Passengers travelling between South Wales and the West of England are being urged to plan ahead as Network Rail undertakes a major programme of engineering work in the Severn Tunnel and wider Bristol area, with replacement bus services and diversionary routes in place to keep people moving.
The vital upgrade will see Network Rail, working alongside contractors ARQ, deliver a comprehensive transformation of the Severn Tunnel’s overhead power system. The project is designed to tackle long‑standing reliability challenges caused by the tunnel’s uniquely harsh environment and to secure the long‑term resilience of one of the UK rail network’s most critical cross‑border routes.
The work will take place continuously from Saturday 23 May until the early hours of Tuesday 9 June, during which time the railway will be closed between Newport and Bristol Parkway.
A world‑first solution for a uniquely challenging tunnel
Running beneath the Severn Estuary, the 4.35‑mile Severn Tunnel is one of the most demanding environments on the UK rail network. High levels of moisture and saltwater accelerate corrosion, placing significant strain on rail infrastructure and requiring frequent maintenance.
Since electrification, the tunnel’s overhead power equipment has been particularly vulnerable to electrical wear and corrosion, increasing the risk of disruption to both passenger and freight services.
To address these challenges, Network Rail’s Wales and Borders team has developed and successfully trialled an innovative new overhead line system. The design replaces multiple components with a single 7km copper contact wire, supported at regular intervals by specially modified bridge arms. By removing corrosion‑prone elements, the new system significantly improves performance and reduces ongoing maintenance requirements.

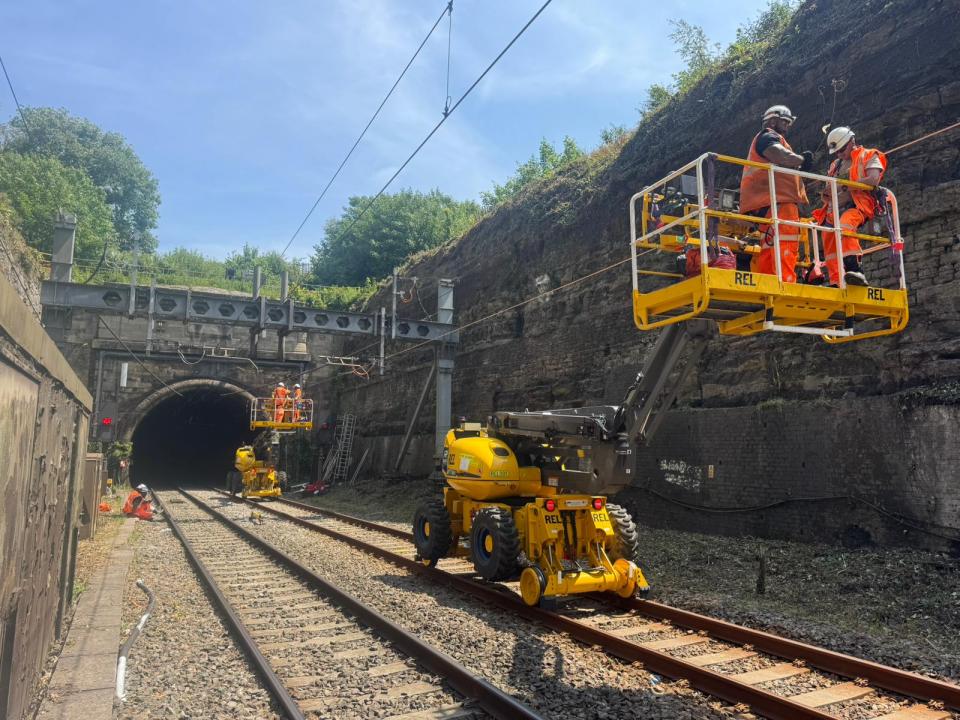

Engineers will now install the system along the full length of the tunnel, using a world‑first approach at this scale, marking a major milestone in UK rail electrification.

Scope of the engineering programme
The intensive programme of work includes:
- Replacing 838 bridge arms that support the overhead electric wires in the Severn Tunnel
- Renewing 9,000 metres of overhead wiring within the tunnel
- Completing track, drainage and wider infrastructure upgrades in the Bristol and Patchway areas
Alongside the tunnel works, Network Rail will also deliver key improvements in the Bristol area, including upgrades to the railway serving the new Bristol Brabazon station, located on the former Filton airfield site.
The station, due to open in the autumn, will see passenger services return to the Henbury line for the first time since 1964, supporting regional connectivity, regeneration and economic growth.
Industry perspective
Nia Watkins, Regional Asset Manager at Network Rail Wales and Borders route, said:
“Running beneath the Severn Estuary, the 4.35-mile Severn Tunnel is one of the most challenging environments on the UK rail network, making this work essential to maintain safe, reliable services and support its long-term future.
“Using an innovative solution developed by our teams at Network Rail, this complex and highly coordinated upgrade is being delivered at a world-first scale across the tunnel’s full length - making the railway more resilient and reducing the risk of future disruption for passengers and freight.
“Alongside this, we’re also renewing track that will serve the new Bristol Brabazon station, which will bring passenger services back to the Henbury and Portishead lines for the first time in over 60 years, supporting local communities and economic growth. The station is due to open later this year and will bring passenger services back to the Henbury line for the first time since 1964."
“We recognise this work requires the temporary closure of the railway between Newport and Bristol Parkway, and we’re grateful to passengers and local communities for their patience while we carry out these important upgrades.”
Keeping passengers moving
During the closure, train operators will provide replacement buses and diversionary routes to minimise disruption. Passengers are strongly advised to check journeys in advance and allow extra time for travel while this essential work is completed.
Once finished, the upgrade will deliver a more robust, reliable railway through the Severn Tunnel, reducing the need for future interventions and helping to safeguard cross‑border rail services for decades to come.
